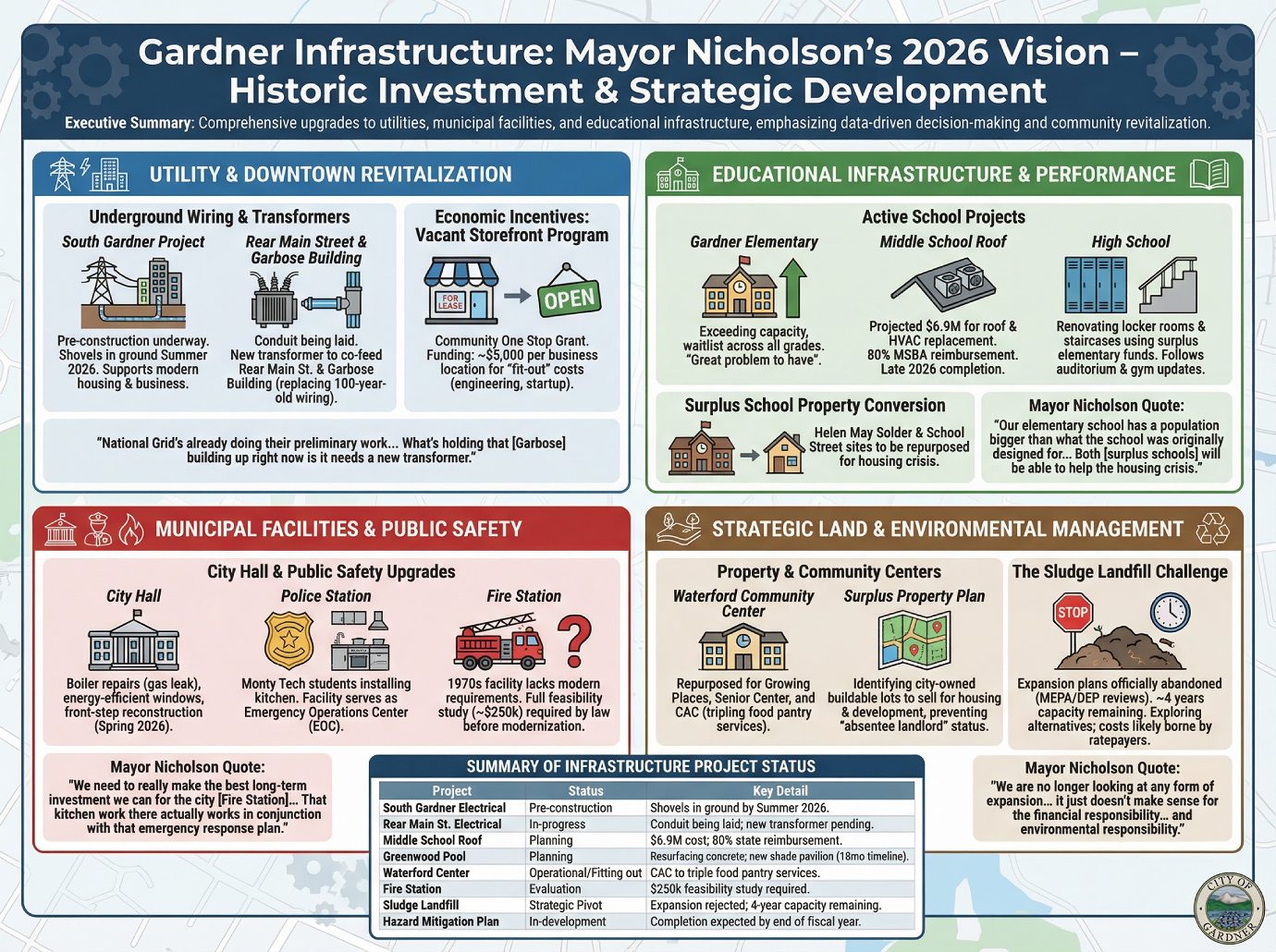

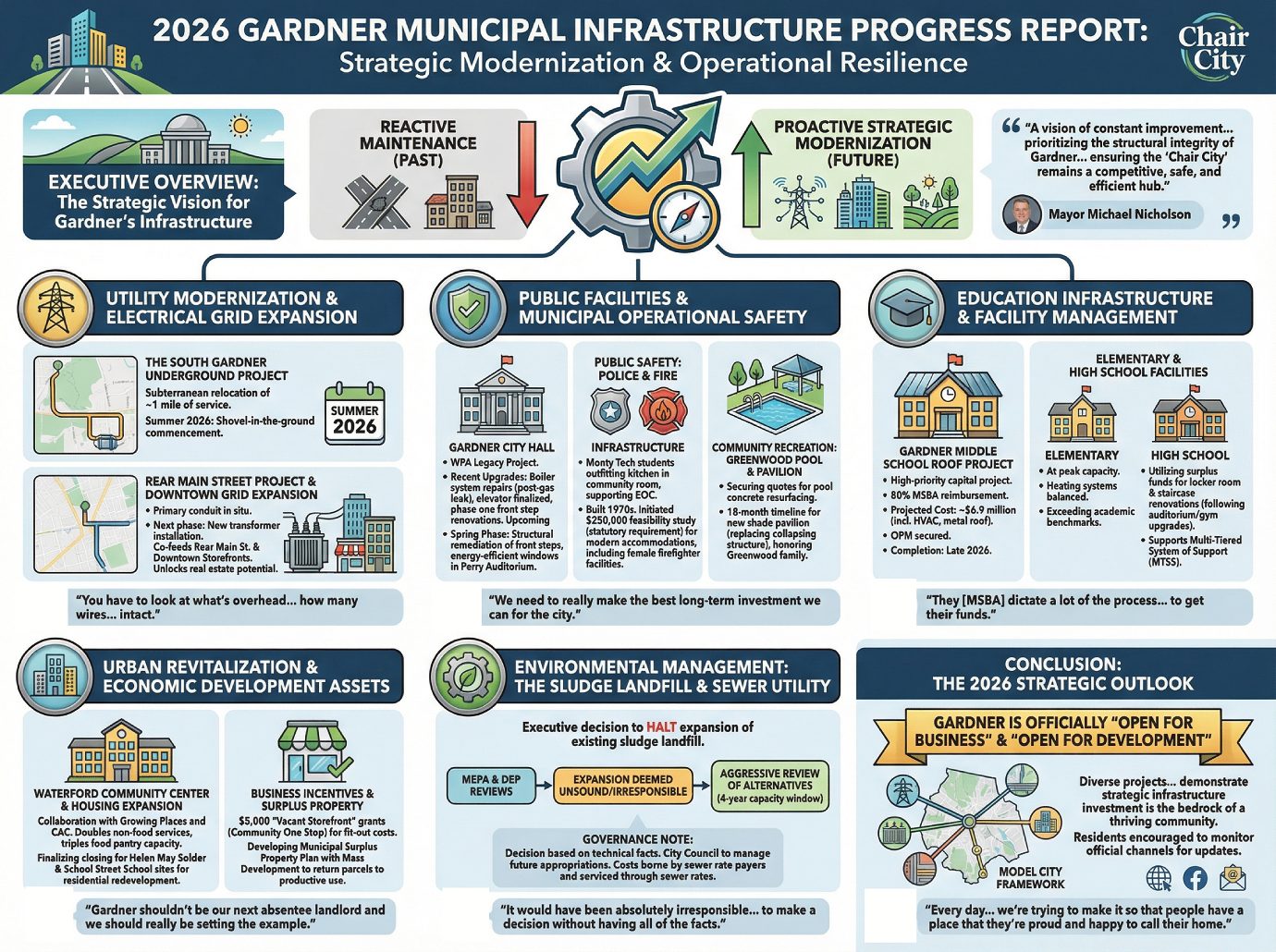

INFRASTRUCTURE โ€“ Interview with Gardner Mayor Michael Nicholson on February 18, 2026
INFRASTRUCTURE โ€“ Interview with Gardner Mayor Michael Nicholson on February 18, 2026

ProjectStatusKey Detail
South Gardner ElectricalPre-constructionShovels in ground by Summer 2026.
Rear Main St. ElectricalIn-progressConduit being laid; new transformer pending.
Middle School RoofPlanning$6.9M cost; 80% state reimbursement.
Greenwood PoolPlanningResurfacing concrete; new shade pavilion (18mo timeline).
Waterford CenterOperational/Fitting outCAC to triple food pantry services.
Fire StationEvaluation$250k feasibility study required.
Sludge LandfillStrategic PivotExpansion rejected; 4-year capacity remaining.
Hazard Mitigation PlanIn-developmentCompletion expected by end of fiscal year.
